YourERPBudgetIsMissingaLineItem:YourPeople'sTime

Your ERP Budget Is Missing a Line Item: Your People's Time
THE MISSING LINE ITEM

“Every ERP proposal has a clean commercial quote: licences, consulting, data migration, support. What none of them have is a line that reads ‘Hours your own managers must give to this project.’ Yet that missing line decides more ERP outcomes than any software feature.”

By Karthik S Hatti, Co-Founder & CBO, Prixgen Tech Solutions
An ERP Is Built From Your Knowledge, Not Just Our Code - Prixgen Executive Advisory
Figure 1: An ERP is built from your knowledge, not just our code. The people who know how your business runs are the ones the project needs most.
30%–50%
Time Required from Key Users
During Solution Design & UAT phases
60%+
ERP Delays Traced to Capacity
Overstretched managers unable to sign off
-18 to -33 hrs
Peak Weekly Capacity Deficit
When project lands on top of day jobs
100%
In-House Delivery at Prixgen
Full-time consultants, zero subcontracting
Interactive Project Phase Simulator

Where the Internal Team Capacity Gap Opens Up

Click across project phases to see how workload spikes create hidden operational risks.
Active Phase Focus

2. Solution DesignBusiness process blueprints, custom logic sign-offs, edge-case definitions

Critical Gap (-18h)
ERP Project Hours Demanded:24 hrs / week
Actual Spare Capacity (While Running Day Job):6 hrs / week
What Happens If Capacity Is Ignored:Workshops demand process owners. If unattended, consultants make generic default assumptions that fail in production.

Figure 3: Demand on internal process owners peaks exactly when the business can least afford it
Figure 3: Demand on internal process owners peaks exactly when the business can least afford it (Illustrative model: gold = demand exceeds realistic availability).
HOW CAPACITY BREAKS AN IMPLEMENTATION

The 5-Step Cascade: From Small Compromises to P&L Defects

Capacity problems never announce themselves loudly. They compound quietly through reasonable-sounding compromises until after go-live:

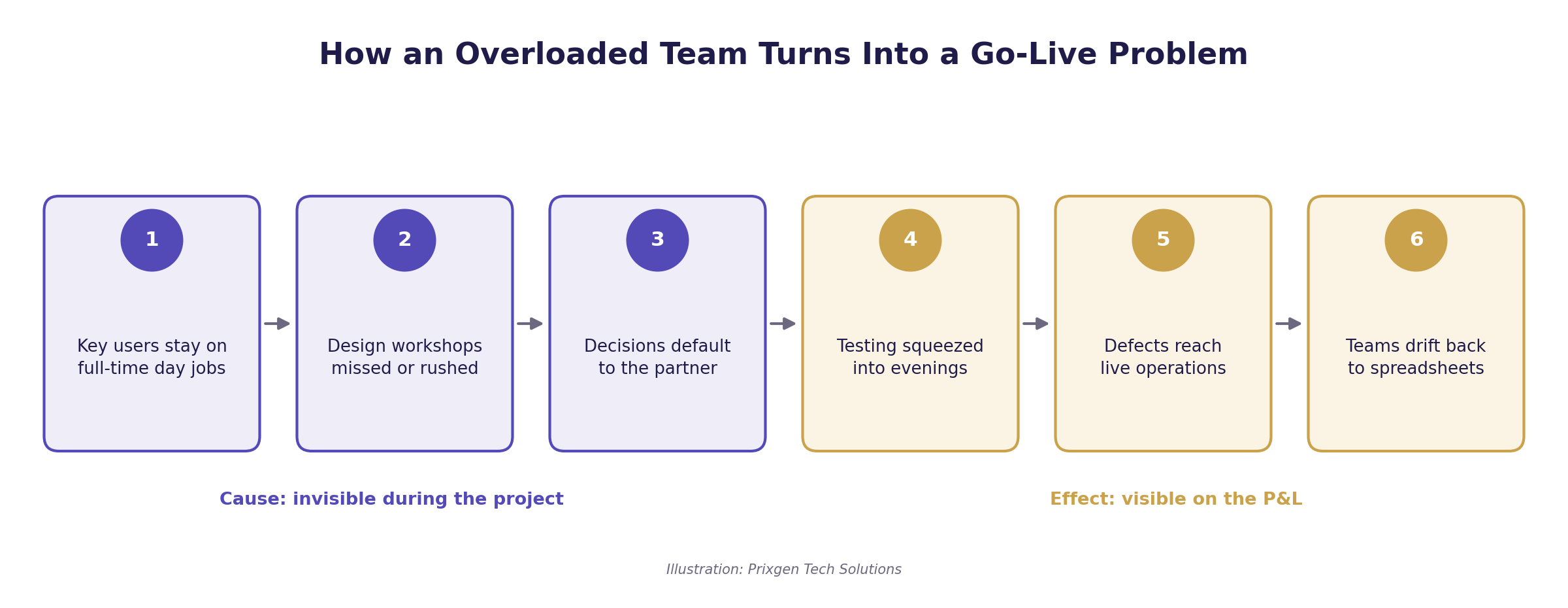

Figure 2: How an Overloaded Team Turns Into a Go-Live Problem
Figure 2: Small compromises during the project become visible business problems after go-live.
STEP 01Month 1–2

Workshops Lose Decision-Makers

Plant managers join for 15 mins; the finance head sends a junior. Needs are noted, but nobody with authority signs off.

STEP 02Month 2–3

Decisions Drift to Partner

When client teams can't decide, consultants make default choices. Good for a generic business, not for yours.

STEP 03Month 4–5

Testing Squeezed to Nights

UAT is done as overtime on happy-path data. Complex edge cases, scrap logs, and GST returns are skipped.

STEP 04Go-Live

Defects Hit the P&L

After go-live, problems land where leadership looks: delayed invoices, wrong stock valuations, and missed dispatches.

STEP 05Month +1

Quiet Retreat to Excel

Users who didn't shape the software distrust it. Shadow spreadsheets return and ERP becomes an expensive data-entry tool.

Warning Signs Your Team Is Already Overcommitted
When the ERP project lands on top of a full day job, something has to give.
Self-Assessment Tool

Is Your Project Carrying Capacity Risk?

Select any warning signals currently present in your enterprise. If 3 or more are active, your implementation requires immediate executive intervention.

0/6
Risk Rating
✅ Healthy Capacity

Absent Process Owners

The same senior department heads repeatedly cancel workshops or send junior delegates without sign-off authority.

Root Cause: Nobody has been released from daily firefighting or routine clerical tasks.

Slow Design Sign-offs

Process blueprints and architecture specifications sit unapproved for 3+ weeks awaiting review.

Root Cause: Decision rights are ambiguous or owners are completely overloaded with operational duties.

Thin Test Evidence

UAT sheets are rubber-stamped with only 3–5 happy-path test runs and zero real-world edge cases.

Root Cause: Testing was squeezed into late evenings after a 9-hour work day instead of blocked working hours.

Master Data Postponement

Item masters, vendor records, and bill-of-materials cleansing gets pushed phase after phase.

Root Cause: No single internal leader owns data hygiene as a measured KPI in their role.

Clashing Enterprise Initiatives

Statutory audits, GST reconciliations, plant expansions, or new product launches happening in the same quarter.

Root Cause: Key financial and operational experts have been double-booked across competing company goals.

Visible Change Fatigue

Middle management and operators respond with visible frustration: 'What system are we supposed to use now?'

Root Cause: Too many procedural changes landing simultaneously on an exhausted workforce.
EXECUTIVE PLAYBOOK

The Prixgen Capacity Readiness Framework

Across 100+ ERP deployments, projects that went live on time shared one habit: capacity was planned as rigorously as software architecture. We run these 6 checks with every client:

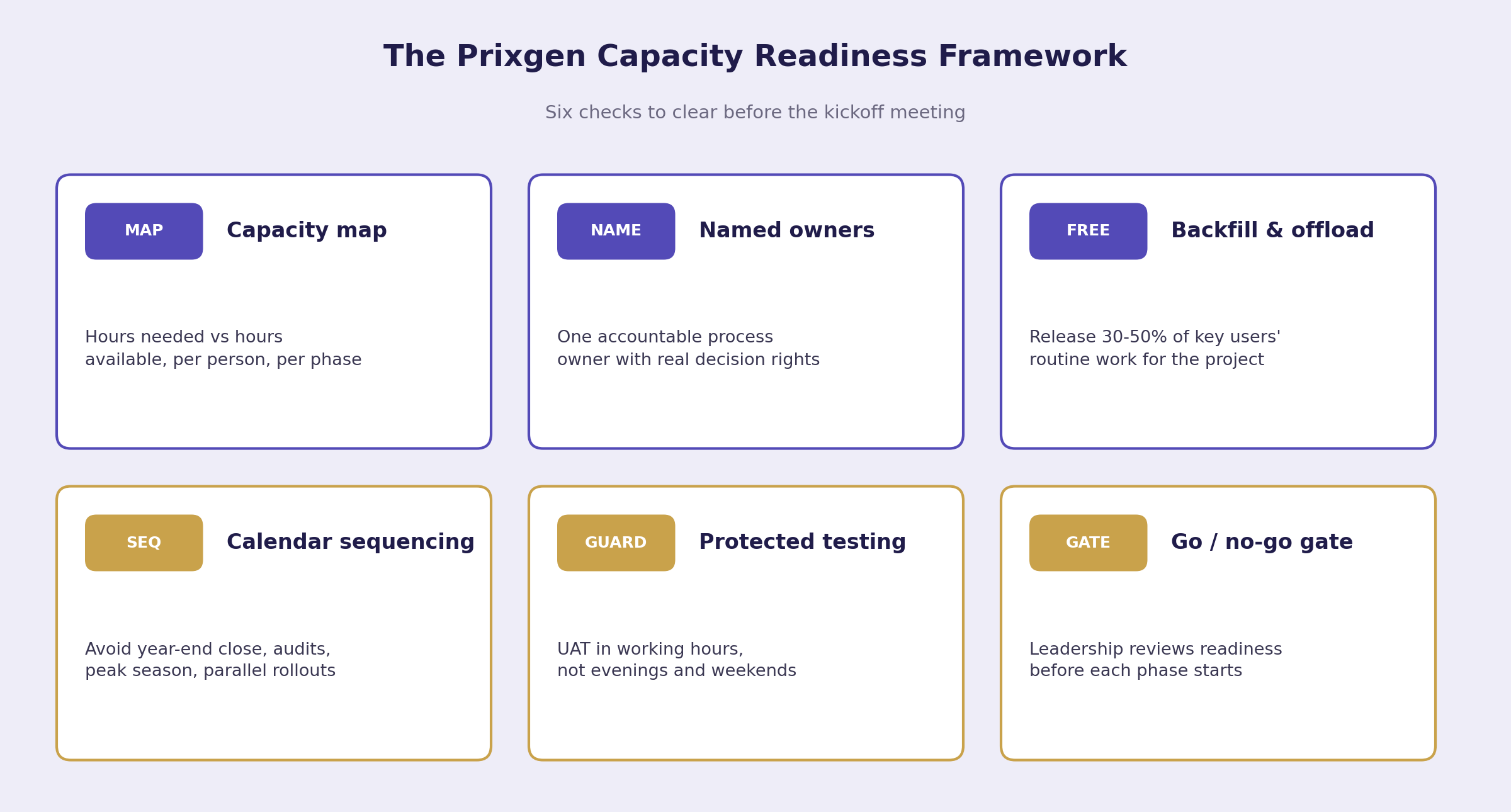

Figure 4: The Prixgen Capacity Readiness Framework - Six checks to clear before the kickoff meeting
Figure 4: Six checks to clear before an ERP project starts.
Free up time through backfill and offloading
In manufacturing, the plant keeps running while the ERP is being built, so project time must be planned around production.
01

Build a Capacity Map Upfront

Map project hours vs realistic availability for every key user on a single page.

Estimate the exact hours required per role and phase (e.g. Finance Head: 18 hrs/wk in Month 2). Compare against actual spare capacity. The gaps become transparent, allowing the board to make resourcing choices before signing.

02

Name Owners with Real Decision Rights

One single accountable owner per process stream with full sign-off autonomy.

From Procure-to-Pay to Extrusion to Order-to-Cash, assign a single owner empowered to make definitive architectural calls. Consensus committees that escalate every toggle will paralyze implementation velocity.

03

Free Up 30–50% Time via Backfill

Budget for temporary backfill and work offloading as legitimate project costs.

During Blueprint and UAT phases, core owners need 30% to 50% of their working week. Offload routine reconciliation, assign temporary coordinators, or pause non-critical projects. If nothing is taken off their plate, the ERP will be.

04

Sequence Around Business Peaks

Lock schedules away from March fiscal closing, GST filings, and peak seasonal demand.

Never schedule Blueprint sign-offs or Cutover during year-end statutory audits or peak dispatch months. Moving a project kickoff by 3 weeks costs zero; rescuing a derailed go-live costs millions.

05

Protect Testing in Normal Working Hours

Conduct UAT with dedicated calendar blocks, realistic data, and complex scenarios.

Testing conducted after hours catches superficial UI glitches and misses multi-department ledger misalignments. Block 4-hour dedicated daytime sprints with real operational scenarios.

06

Enforce Go / No-Go Capacity Gates

Before transitioning to the next phase, verify internal team availability.

Leadership must ask one plain question before Design, Build, and Go-Live: 'Are our people genuinely ready and available for this next phase?' If not, phase the scope or pause. Starting with an unavailable team always finishes late.

What Leadership Should Do This Quarter

5 low-cost executive actions that dramatically improve ERP success odds:

1. Demand Internal Effort Estimates

Ask your implementation partner to quote client-side hours by role and phase—not just their own consultant rates.

2. Cross-Check Annual Initiatives

List every major corporate initiative planned for the next 12 months and verify which key people appear in more than one.

3. Formalise What to Stop

Document in writing what your core process owners will delegate, postpone, or halt during Blueprint & Testing.

4. Budget Backfill as Project Cost

Treat temporary backfill salaries as legitimate project expenses, alongside software licences and partner fees.

5. Align User Appraisals to Project

Make ERP milestone delivery a formal part of key users' annual review goals so project effort is rewarded, not squeezed.

A Strategic Note on Phasing

If capacity is tight, a phased rollout (Finance & Inventory first, then Manufacturing) is far wiser than high-risk big-bang releases.

THE PRIXGEN COMMITMENT

How Prixgen Protects Clients from Capacity Risk

Internal Effort Upfront

Our proposals explicitly project expected client-side hours by department, so leadership can resource appropriately before signing.

100% In-House Payroll

We never subcontract functional or technical delivery. Our dedicated consultants maintain accountability and team continuity.

Chartered Accountants In-House

Qualified finance consultants shoulder complex tax, GST, and closing design, relieving pressure on your internal accounting teams.

Readiness Gate Governance

Every phase begins with an honest readiness checkpoint. We will advise a phased schedule whenever it protects the client's outcome.

EXECUTIVE FAQS

Frequently Asked Questions on ERP Resourcing

It varies by company size and scope, but during Solution Design and User Acceptance Testing (UAT), core process owners typically need to commit 30% to 50% of their working week (15 to 25 hours). Outside those peak phases, demand drops to 6–10 hours per week. The critical requirement is estimating it phase-by-phase and protecting that time on the calendar, rather than assuming it can simply be squeezed on top of a 50-hour day job.
